Last reviewed: July 2026
Step 1
Choose the calculation you want to run
At-a-Glance
- •Default Mode handles one deadline or the difference between two dates
- •Court Rules applies Hong Kong court counting rules to one period
- •Sequential Periods joins two or more working-day stages
Start with the question you need the calculator to answer. The three cards at the top of the form change the controls below them.
Default Mode
Court Rules
Sequential Periods
The calculator counts the period; the source supplies it
Before entering anything, identify the document, contract or rule that gives you the start event, the length of the period, and whether either boundary date counts.
Working-week choice
Decide whether Saturday counts
At-a-Glance
- •The Business Context control appears in Default Mode for working-day calculations
- •Standard leaves out Saturdays, Sundays and General Holidays
- •SFBC Construction leaves out Sundays and General Holidays, so Saturday can count
Check the working-day definition in the document you are using. Then select the matching Business Context. The control is hidden for calendar-day calculations because weekend days already remain in that count.
Standard: Saturday excluded
SFBC Construction: Saturday included
This is a user choice
The calculator cannot tell which working week applies from the transaction name. Choose SFBC Construction only when the contract uses that convention.
Default Mode
Run a standard date calculation
At-a-Glance
- •Choose Deadline when you know a start date and a period
- •Choose Difference when you already know both dates
- •Use the Calendar days switch only when the period is stated in calendar days, weeks or months
Select Default Mode. Then work through the visible controls from left to right.
Open full sizeExample: five Hong Kong working days
To add five ordinary working days, choose Deadline, Forward, leave Calendar days off, select Standard, enter the trigger date and 5, then set the boundary checkboxes to match your source. After calculating, open Excluded Dates to see every weekend and General Holiday left out.
Example: how the boundary checkboxes move the date
Start on Monday 2 March 2026 and add 3 Standard working days. With Include start date off and Include deadline date on, the counted days are Tuesday, Wednesday and Thursday, so the result is Thursday 5 March. Turn Include start date on and Monday becomes day 1, moving the result to Wednesday 4 March. If Include deadline date is off instead, the calculated date sits after the third counted day and the result moves to Friday 6 March.
Example: one calendar month

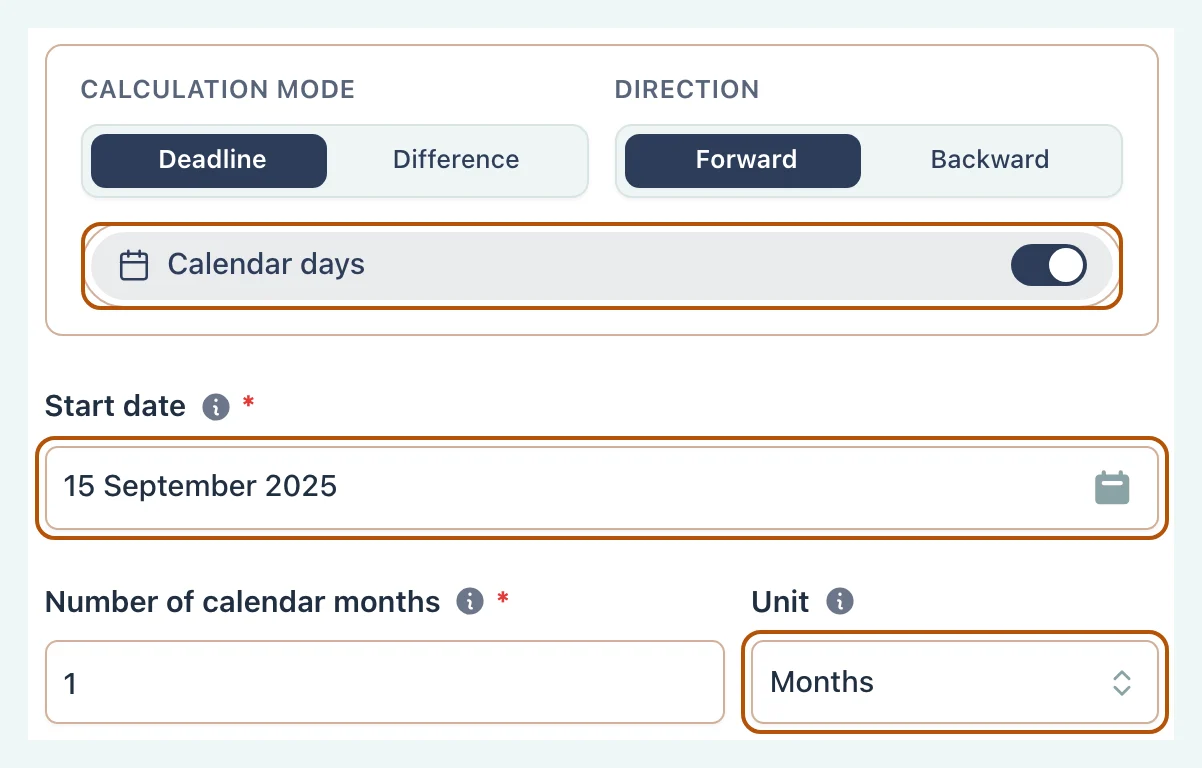

For the employment example, choose Deadline and Forward, turn on Calendar days, set Unit to Months, enter 15 September 2025 and 1, and include both boundary dates. The result is Tuesday 14 October 2025. Weekends and General Holidays stay inside a calendar-month period.

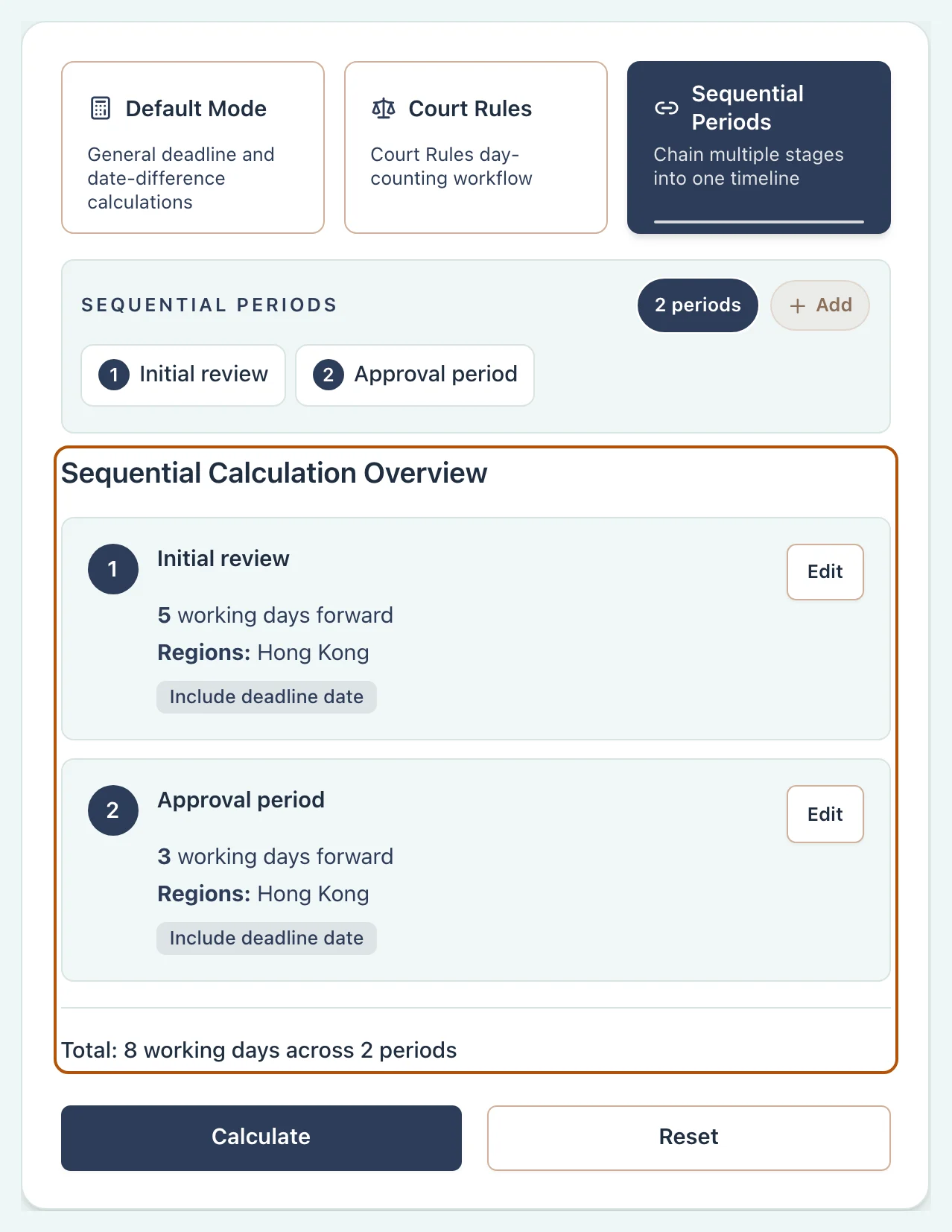

Follow a completed setup
Court Rules
Use the Hong Kong Court Rules workflow
At-a-Glance
- •Notice counts backward; Filing counts forward
- •Periods of 7 days or less use working days; longer periods use calendar days
- •Saturdays, Sundays and General Holidays are non-court days for a short period
Select Court Rules only after checking the court rule for your step. The form displays the counting method as you change the number of days.

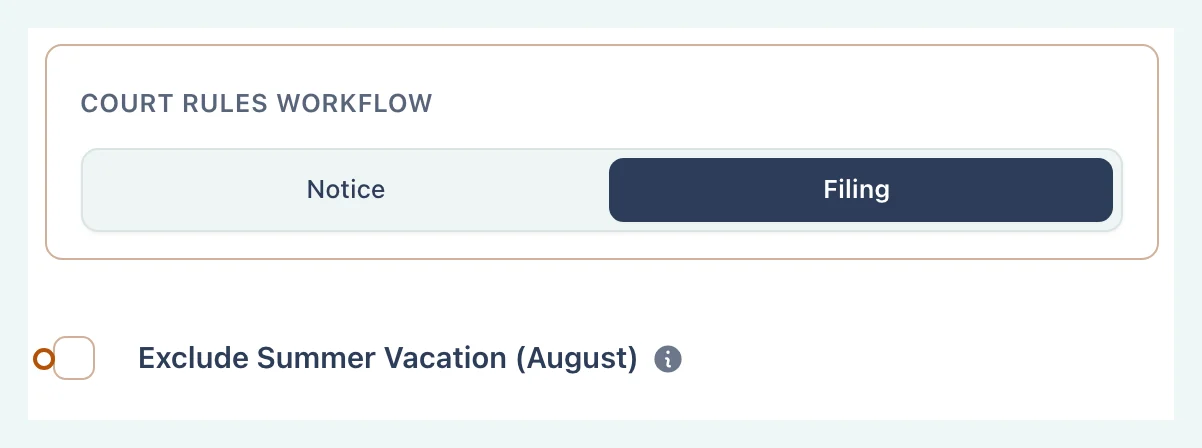

Open full sizeWhat the workflow applies
The result identifies the court profile and counting method. If the selected profile moves the final date, the result shows both the calculated date and the open-court date. Check Order 3 and the rule for your step to confirm that the final-day treatment applies to that act and filing method. The calculator cannot predict gale warning or Black Rainstorm days, so check actual closures before relying on the date.
Example: the seven-day threshold
In Filing, start on Wednesday 7 January 2026 and leave the start date out. A 7-day period uses working days and ends on Friday 16 January. Change only the period to 8 days and the workflow uses calendar days, ending on Thursday 15 January. Check the method shown in the result as well as the date.
Related Resources
A complete short-period court example
What happens when weather disrupts a court day
Official Hong Kong e-Legislation text
Official Hong Kong e-Legislation text
Official practical summary of the days excluded from periods of 7 days or less
Topic
Use the optional August exclusion
Apply the August exclusion only to a High Court pleading rule that requires it.
Topic
Use shutdowns and build sequential periods
Join known working-day stages without inventing the event that triggers the next stage.
Results
Check what the result actually counted
At-a-Glance
- •The headline gives the result date or the number of days
- •The breakdown separates working days, weekends, holidays and shutdown days
- •Excluded Dates lists the individual dates left out
Do not stop at the large date. Read the settings and the excluded-day list beneath it before using the result.

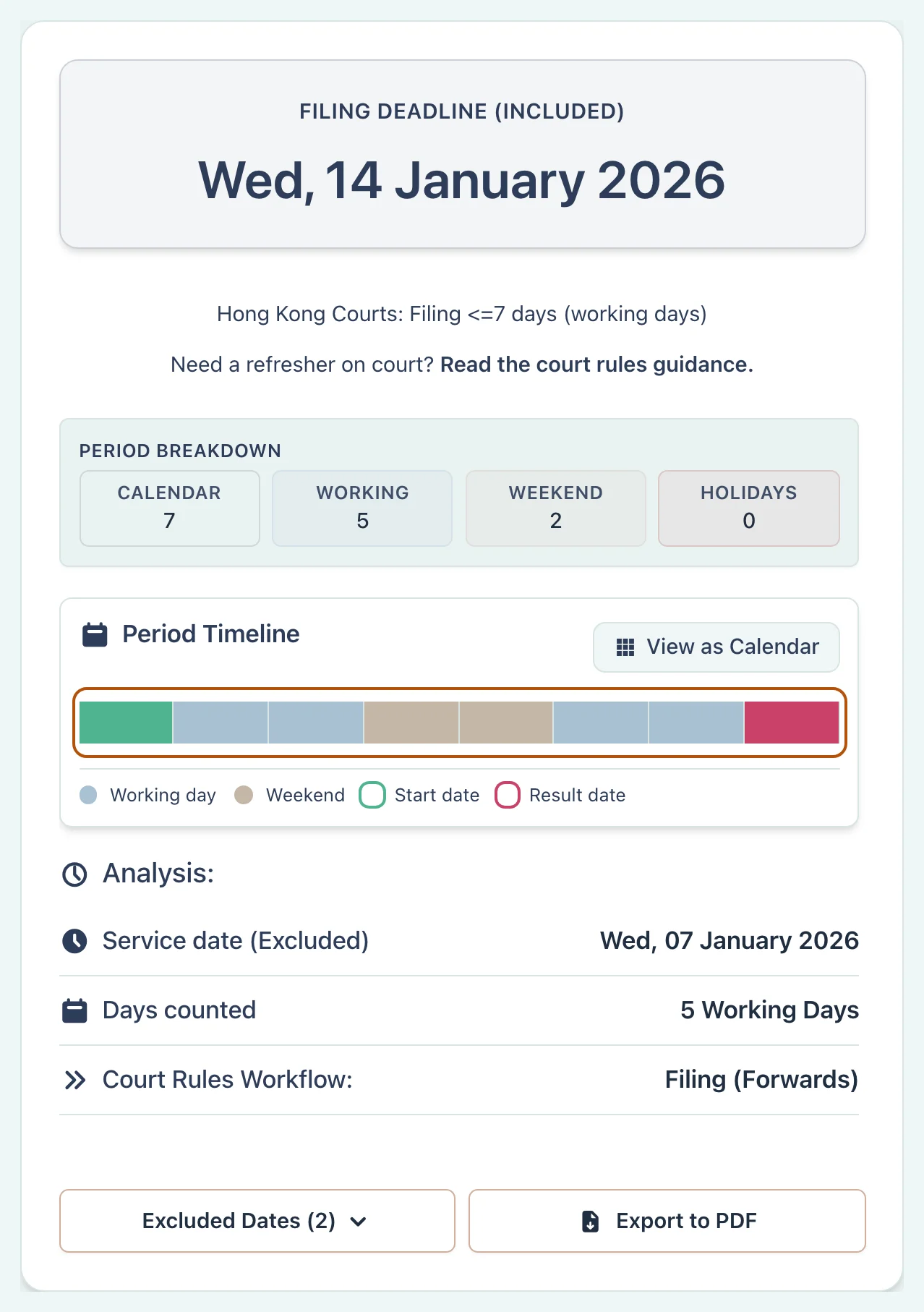

Open full size1. Check the summary
2. Check the breakdown
3. Open Excluded Dates
4. Check court adjustments
Use Calendar View for a day-by-day view, or export the result when you need a record of the settings and excluded dates you checked.
Practise reading a result
Topic
Troubleshooting
Find the setting most likely to explain an unexpected result.
